Getting ready

  • Remove bowsprit
  • Prepare engine
  • Tow to Seaview Marina
  • Remove engine and standing rigging

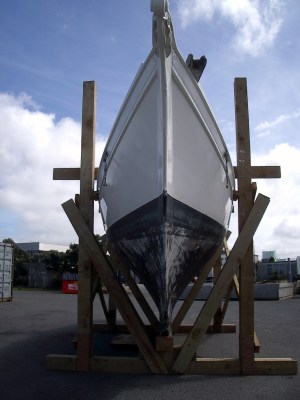

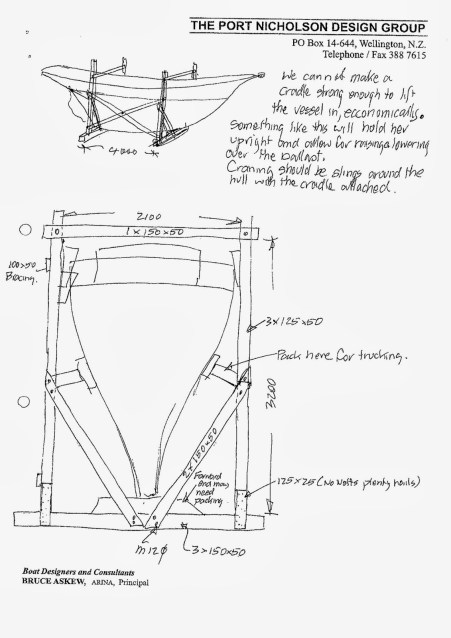

  • Build cradle

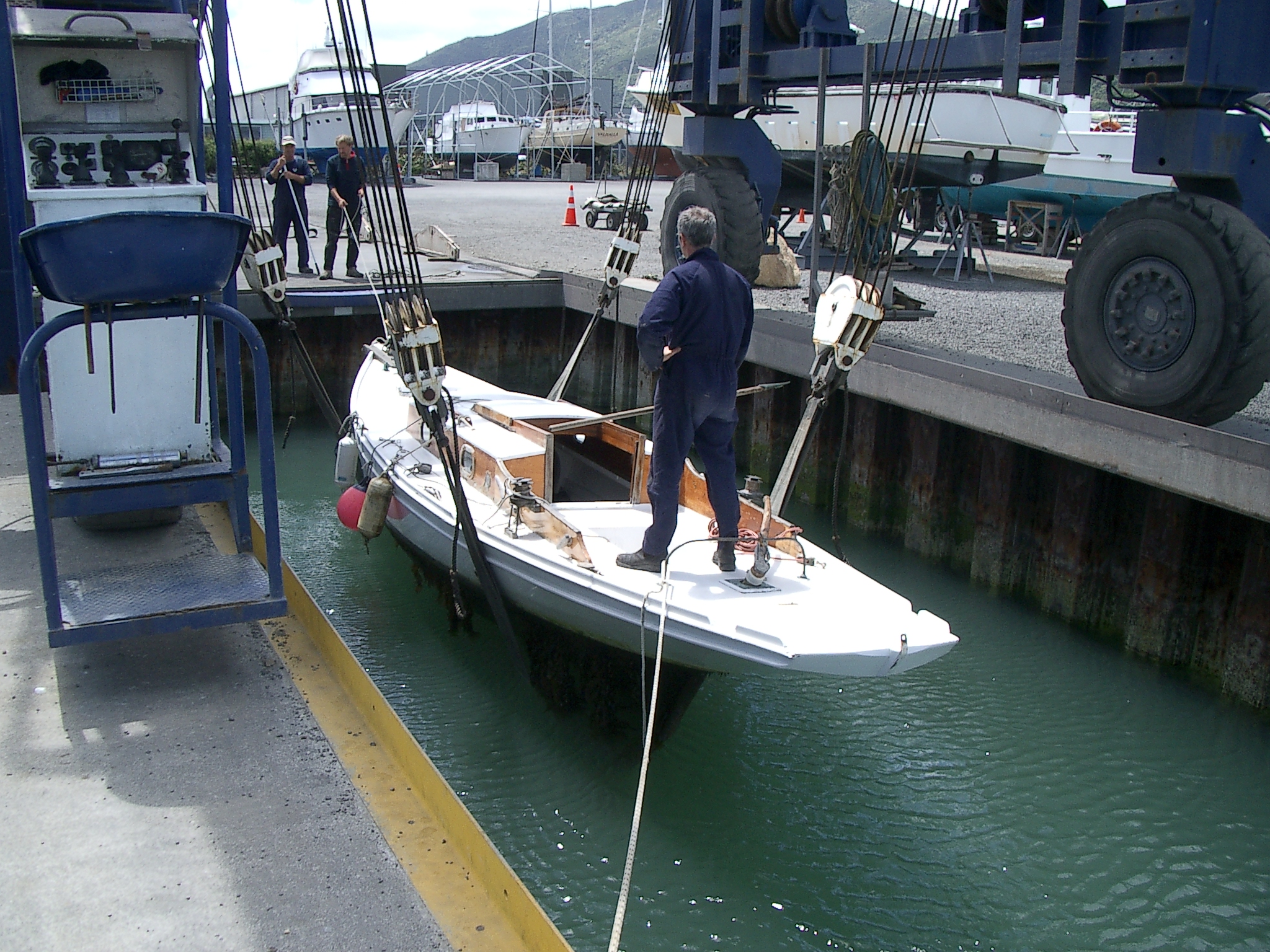

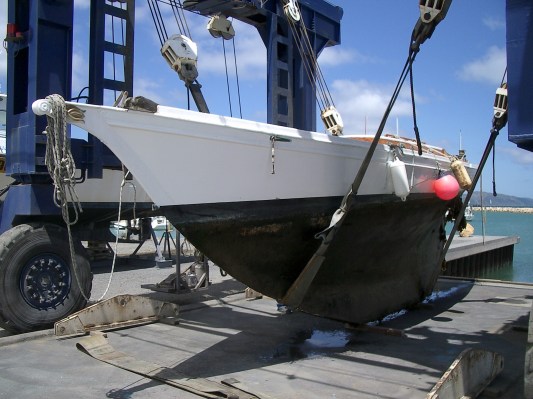

  • Slip

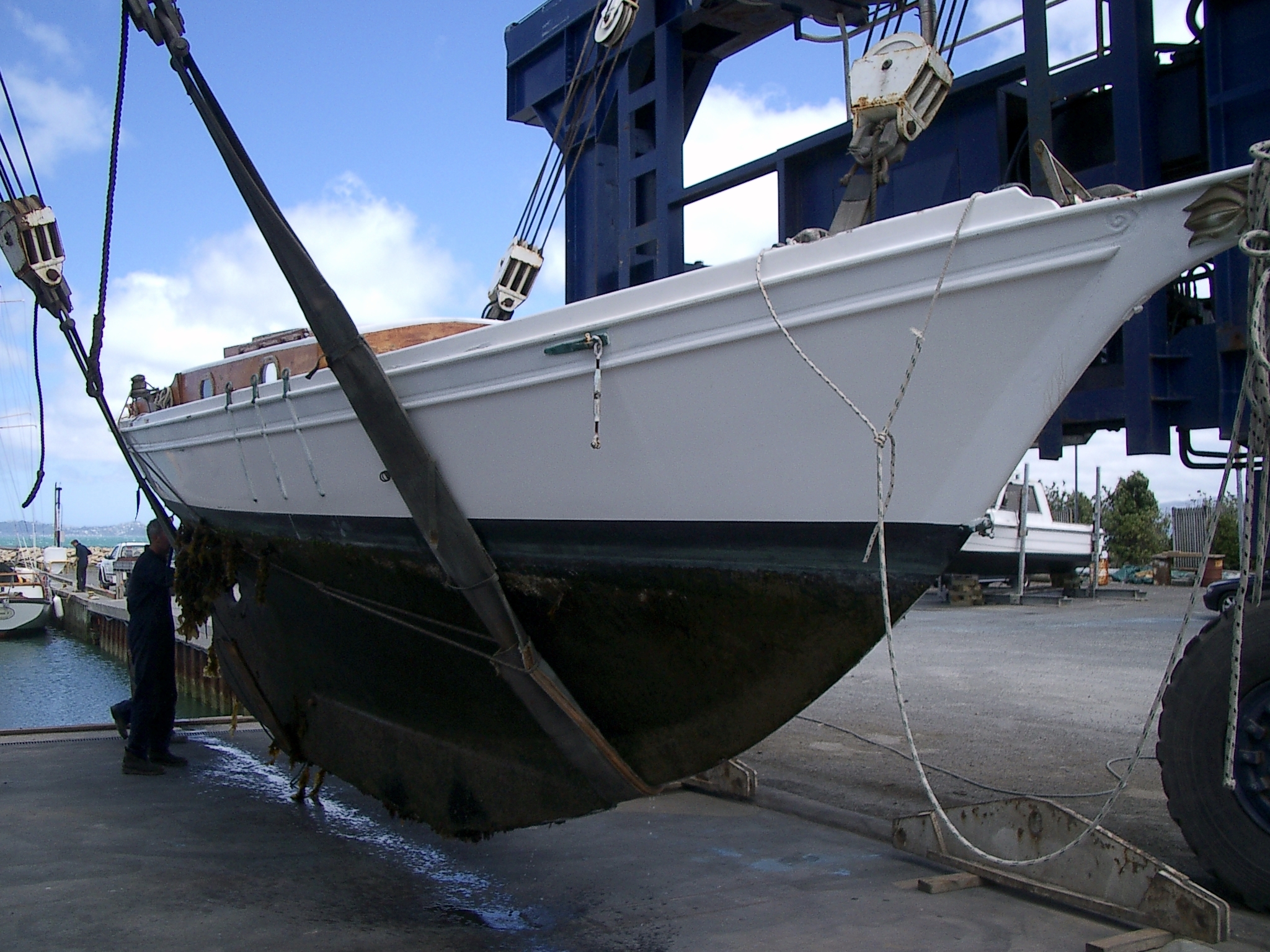

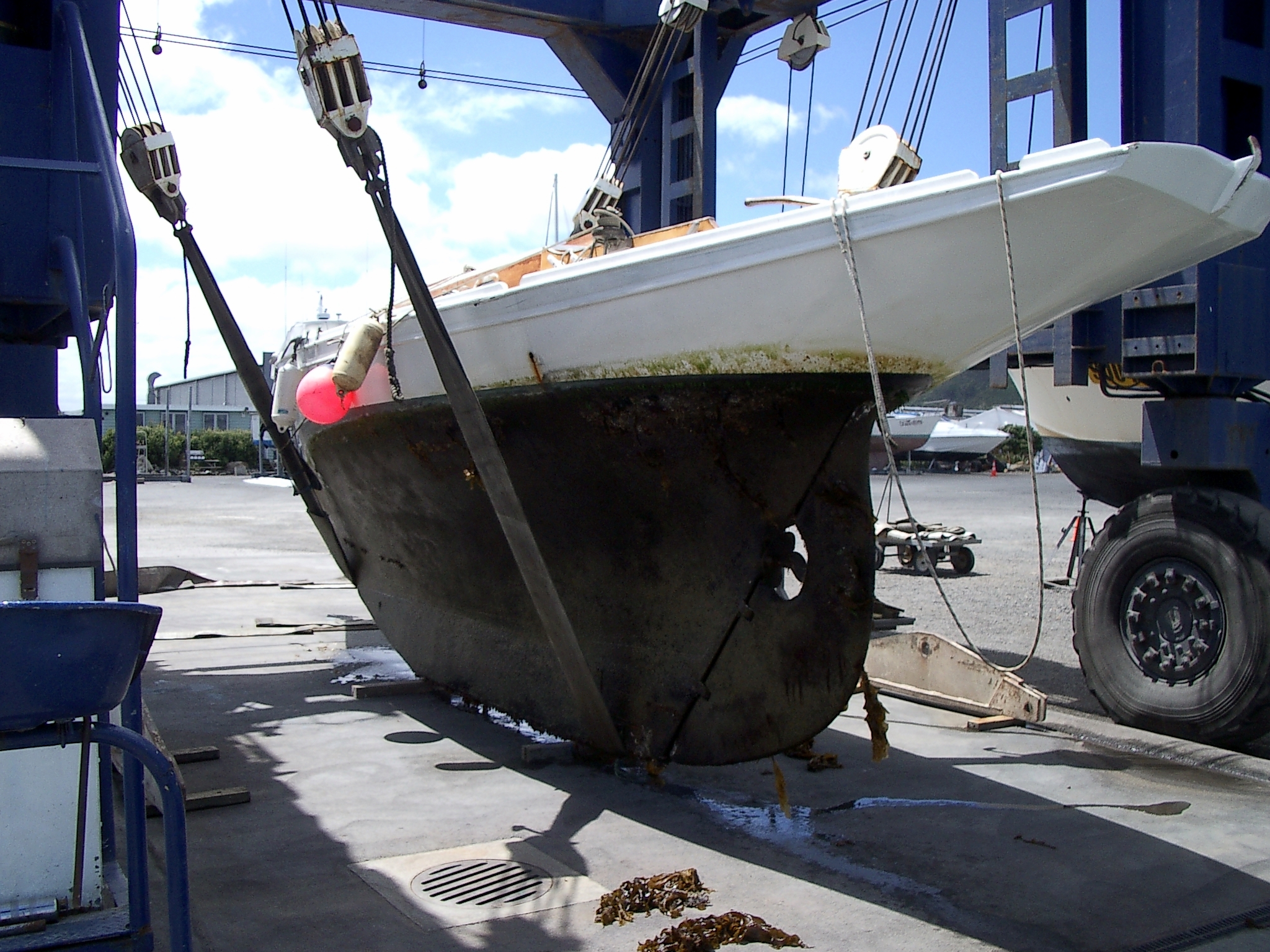

  • Waterblast hull

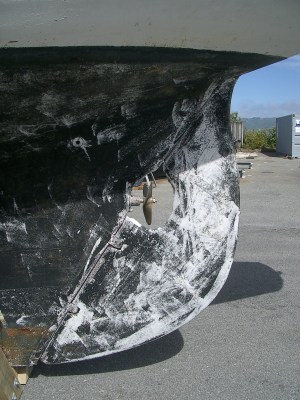

  • Remove internal ballast
  • Pump out bilges

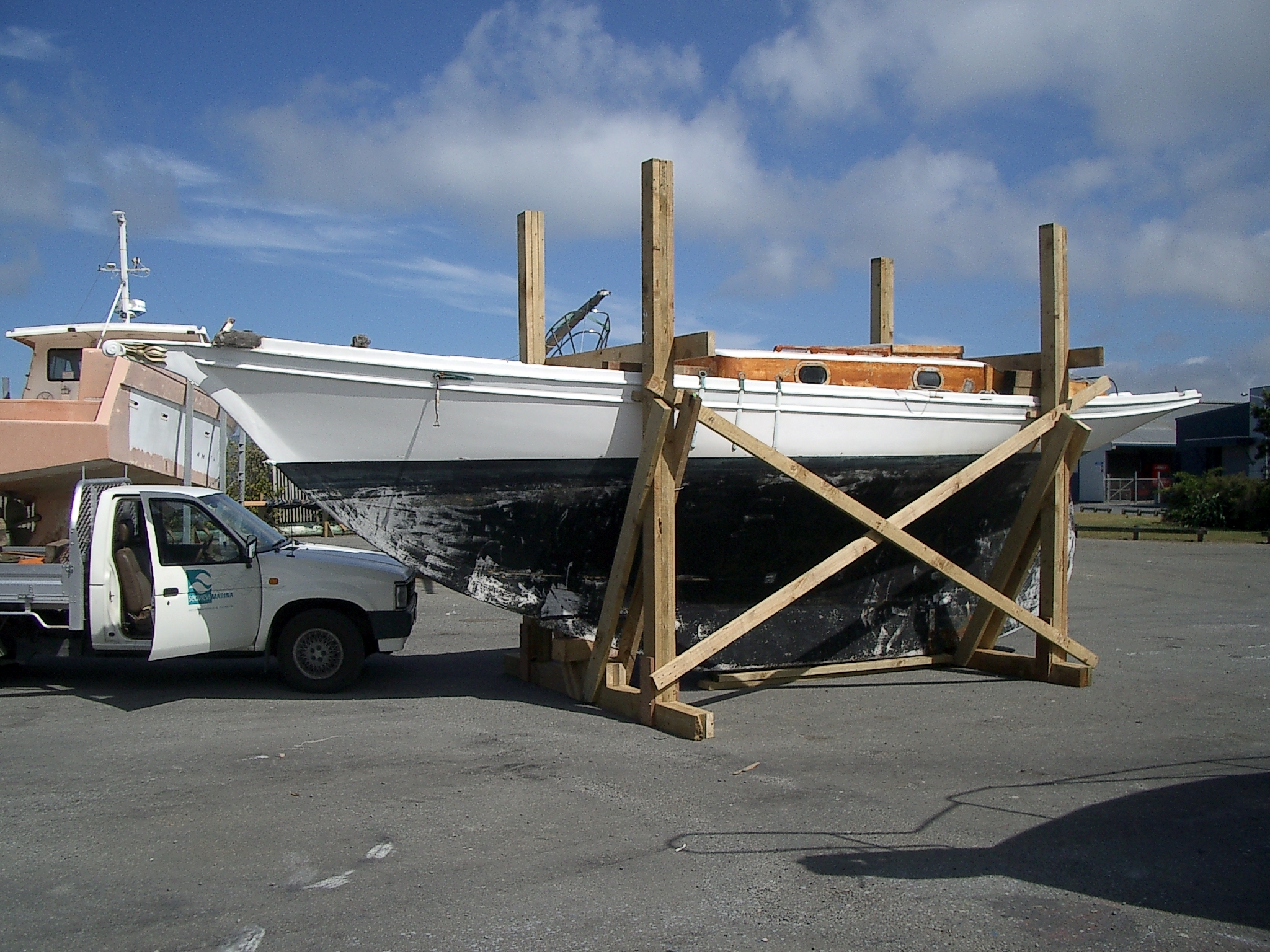

  • Load onto transporter
  • Deliver to outside workshop
  • Transfer into workshop
  • Remove keel bolt nuts and washers
  • Remove keelson
  • Drill around keel bolts
  • Wedge keel off and cut bolts beneath hull
  • Drive bolts from hull
